How to Create A Quality Inspection Plan for Manufacturing

How to Create A Quality Inspection Plan for Manufacturing

A quality inspection plan for manufacturing should define what will be inspected, when it will be inspected, how sampling will work, what counts as a defect, what evidence the report must include, and who decides release, rework, hold, or reinspection. Without those rules, inspection becomes a late factory visit instead of a control system.

Many buyers ask for inspection too late. They send a PO, wait for production to finish, and then ask an inspector to check the goods. The inspector may still find defects, but the plan is already weak because the product file, defect classes, special checks, sampling level, packing rules, and escalation path were not frozen before production.

The ISO 10005:2018 overview is helpful because it treats quality plans as documents that establish, review, accept, apply, and revise controls for a process, product, service, project, or contract. For importers, the quality plan is the bridge between a purchase order and an inspection report.

ISO 9001:2015 also gives the right operating mindset: a manufacturing process should consistently meet customer and regulatory requirements. A buyer does not need to copy ISO language into every PO, but the inspection plan should make requirements measurable and auditable.

The broader ISO 9000 family is also useful context because it focuses on consistently meeting customer expectations. For importers, that expectation has to be converted into inspection evidence before the order ships.

  • Start before production: freeze the product spec, approved sample, defect classes, and special checks before materials are committed.
  • Use checkpoints: match PPI, DPI, PSI, and loading checks to the risks that appear at each stage.
  • Make defects measurable: define critical, major, and minor defects with visual examples where possible.
  • Make reports decision-ready: require sample math, photos, quantities, packaging checks, and release rules.

What Should a Manufacturing Quality Inspection Plan Include?

Create a manufacturing quality inspection plan by defining the product specification, risk points, inspection stages, sampling method, defect classification, acceptance criteria, report evidence, corrective-action rules, and final release authority before production starts.

For sampled inspection, ISO 2859-1:2026 provides the lot-by-lot sampling framework indexed by AQL. The inspection plan should specify the sample size logic and defect limits instead of leaving the factory and inspector to improvise.

For inspection service reliability, ISO/IEC 17020 describes requirements for competence, impartiality, and consistent operation of inspection bodies. The buyer should still check the service scope, report format, communication speed, and product-category experience.

TradeAider also provides an AQL calculator and an inspection standard resource that can help buyers translate lot size, defect classes, and checklist expectations into inspection instructions.

For importers, the plan also supports documentation discipline. CBP Reasonable Care is customs-focused rather than a manufacturing checklist, but the principle still applies: importers need careful evidence instead of supplier assurances alone.

Manufacturing Inspection Plan Checklist

A usable plan connects each requirement to timing, evidence, and a release decision.

Plan ElementWhat to DefineCommon GapBest Output
Product fileSpecs, drawings, approved sample, tolerancesBuyer sends only photosFrozen order control file
Risk mapSafety, function, appearance, packaging, label risksAll checks treated equallyRisk-ranked checklist
Checkpoint timingPPI, DPI, PSI, loading supervisionInspection only after packingStage-by-stage control plan
Sampling ruleLot size, AQL level, defect classesNo sample math agreedAccepted sampling plan
Defect classesCritical, major, minor examplesFactory disputes severityVisual defect guide
Report evidencePhotos, counts, measurements, carton marksSummary verdict onlyDecision-ready report
Release ruleShip, hold, sort, rework, reinspectNo owner for next stepWritten action rule

The plan should be short enough for factory execution and specific enough for dispute prevention. If it becomes a 40-page document nobody reads, it will fail. If it is only a one-line request to check quality, it will also fail.

The highest-value inspection plan tells the inspector what evidence matters. For example, a cosmetic product may need fill level, label, batch code, packaging, leakage, and regulatory warning checks. A metal bracket may need dimensions, coating, burrs, hole position, thread fit, load-related visual checks, and carton strength.

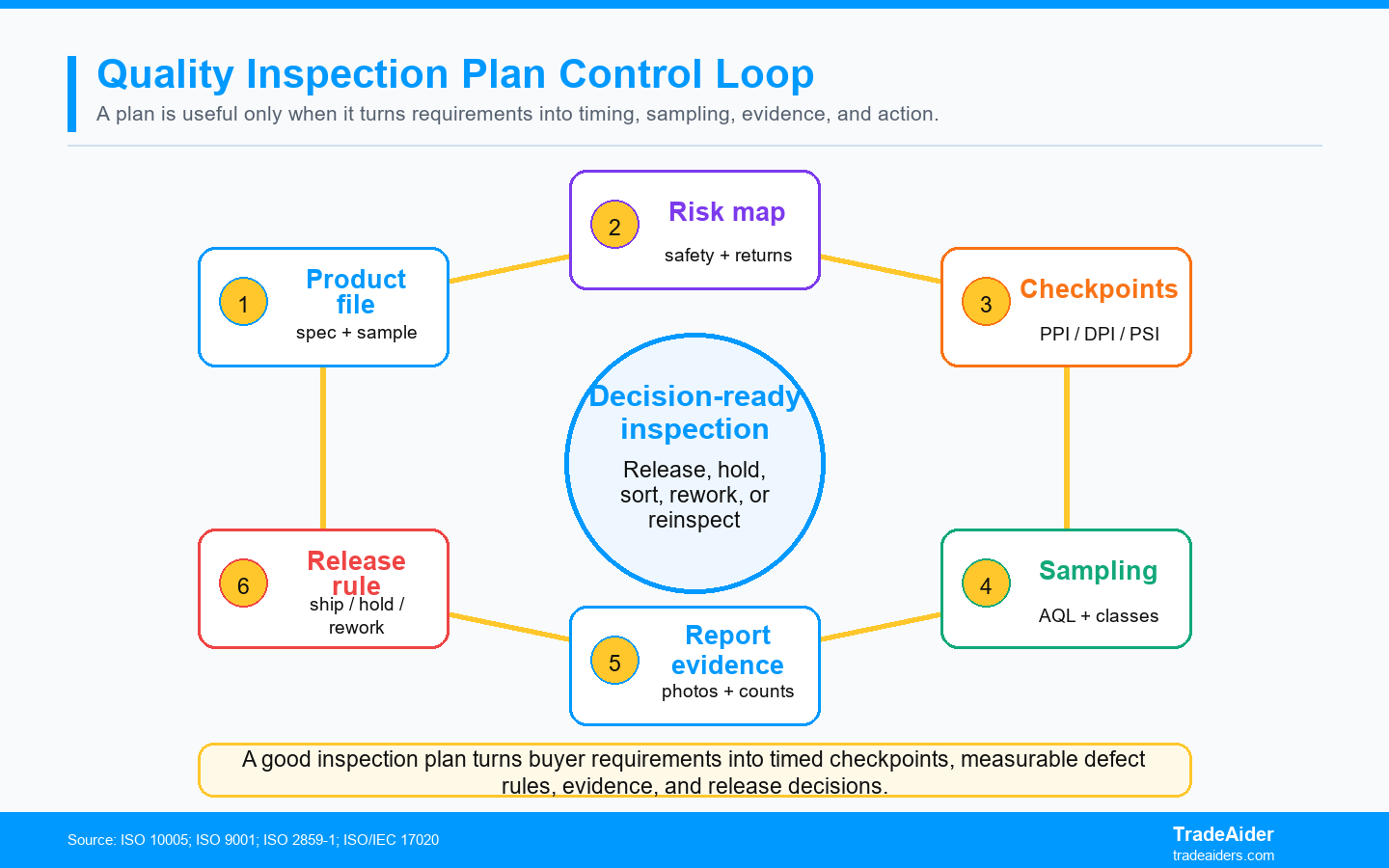

A good inspection plan turns buyer requirements into timed checkpoints, measurable defect rules, evidence, and release decisions.

A good inspection plan turns buyer requirements into timed checkpoints, measurable defect rules, evidence, and release decisions.

Step 1: Build the Product Control File

Inspection can only enforce requirements that the buyer has made visible.

Freeze the approved sample and specification together

A golden sample is not enough unless it is supported by measurable specifications. The sample shows the expected result, but the spec tells the factory and inspector how to judge it. Include dimensions, materials, colors, finish, tolerances, labels, accessories, packaging, barcode, warnings, artwork version, and functional performance requirements.

The control file should also define what cannot change without approval. Material substitution, component change, mold change, artwork revision, packaging replacement, or subcontracting should trigger written approval. Otherwise, the factory may treat changes as normal production decisions.

Use product risk to decide inspection depth

A low-cost decorative item does not need the same inspection depth as an electrical appliance, baby product, toy, cookware item, furniture item, or marketplace-restricted product. The inspection plan should rank risks by safety, compliance, function, appearance, packaging, return cost, and brand damage.

Risk ranking prevents two bad habits: over-checking harmless details and under-checking shipment blockers. The buyer should tell the inspector which failures are critical, which are major, and which are minor, then attach examples so the classification is not invented at the factory.

Step 2: Choose the Right Inspection Checkpoints

The timing of inspection should match when the risk becomes visible.

Use PPI before production locks in the wrong input

Pre-Production Inspection is useful when materials, components, tooling, artwork, or factory readiness can drift before production starts. It is not only a factory visit. It is a way to check whether the supplier is ready to produce the approved product, not merely a product that looks similar.

PPI is especially useful for new suppliers, custom materials, new molds, private-label packaging, seasonal deadlines, and first orders. Catching a wrong component before assembly is cheaper than sorting a packed shipment.

Use DPI when process drift can still be corrected

During Production Inspection checks the lot while output is still being made. It is valuable when defects can be corrected before the full order is packed. It can identify workmanship drift, material mismatch, assembly errors, function failure, label issues, or weak packing before they become a finished-lot dispute.

DPI should not replace PSI when final packing evidence matters. It answers a different question: is production on track early enough to correct the process?

Use PSI when the finished lot is ready for release

Pre-Shipment Inspection should be performed when 100% of the order quantity is completed and at least 80% is packed for export. That timing matters because the inspector can sample from a shipment-ready lot and check real packaging, labels, quantity, workmanship, function, and carton marks before final balance payment or loading.

If the buyer uses PSI as the first and only quality control point, the plan must be especially clear. The inspector cannot rebuild a weak product file during one factory visit.

Step 3: Define Sampling, Defects, and Special Checks

AQL is powerful only when the buyer defines what counts as failure.

Separate sampled defects from zero-tolerance checks

AQL works for sampled inspection of visible or testable defects. It should not be used casually for issues where one failure is unacceptable, such as missing safety warning, wrong SKU, wrong label, incorrect plug, wrong voltage marking, missing compliance document, hazardous sharp edge, or identity mismatch.

The plan should identify which checks are AQL-based and which are zero-tolerance release gates. This prevents a shipment from passing overall AQL while still containing a critical market blocker.

Make defect classes visual and product-specific

Critical, major, and minor classes should not be generic words. The plan should give examples: broken insulation is critical for an electrical item; loose stitching may be major for apparel; small color shade variation may be minor if it is within the approved tolerance. The more specific the examples, the less room there is for factory argument.

Include measurement tools, test methods, duration, sample quantity, and reference photos where needed. A checklist that says check function is too vague; a checklist that says run each sampled item for 60 seconds and record failure type is usable.

Assign an owner for every release rule

An inspection plan fails when nobody owns the next decision. If the report fails major defects, who tells the supplier to sort? If the result is hold, who decides whether concession is acceptable? If only one SKU fails, who approves partial release? These decisions should be named before the inspection date because factories often push for immediate approval when loading pressure starts.

The owner does not need to be a large team. For a small importer, it may be the founder, sourcing manager, or operations lead. What matters is that the inspector, supplier, and buyer know who can approve rework, reinspection, discount, shipment hold, or release under written conditions. Without this owner, a detailed report can still produce a confused decision.

A Practical 100-Point Inspection Plan Score

Score the plan before production to expose weak control areas.

Use a 100-point readiness screen: 20 points for a complete product control file, 15 for risk-ranked checklist, 15 for checkpoint timing, 15 for sampling and defect classification, 15 for report evidence requirements, 10 for corrective-action rules, and 10 for release authority. Any plan under 75 points is likely to create arguments at final inspection.

This score is not a certification tool. It is an importer discipline tool. It tells the buyer whether the inspection plan is ready before production starts. If the product file is only photos and messages, the score should be low even if the supplier promises good quality.

A useful plan also has revision control. When a shipment fails, when a customer returns a product, or when a supplier changes a component, the next order's inspection plan should be updated. The plan should become smarter after every shipment.

Revision control is especially important for repeat suppliers because familiarity creates blind spots. Buyers often keep using the same old checklist even after defects, returns, or packaging complaints reveal new risk. A stronger approach is to add one line to the inspection plan for every meaningful incident: what happened, how it will be checked next time, what evidence is required, and what result triggers hold or reinspection.

Where TradeAider Fits in Manufacturing Inspection Planning

TradeAider fits by translating the buyer's product file into inspection checkpoints, AQL rules, report evidence, and real-time release decisions.

If the order is still before production, TradeAider can support Pre-Production Inspection to confirm materials, samples, components, packaging files, and supplier readiness before the factory locks in the wrong input.

If the buyer needs process visibility while goods are being made, During Production Inspection can check early output and help the buyer decide whether to correct, continue, or escalate before the full lot is packed.

If the shipment is ready for release, Pre-Shipment Inspection converts the plan into evidence: sample math, defect counts, photos, measurements, packing checks, label checks, carton marks, and a decision that the buyer can act on.

SPAR Scenario: The Plan Caught a Packaging Failure Before Shipment

The buyer avoided a warehouse relabeling problem because the inspection plan named the risk early.

Situation: A Canadian importer orders 12,000 private-label household products from a first-time factory.

Problem: The product works, but packaging artwork has three versions and the factory is using an old barcode file for part of the order.

Action: The buyer puts barcode scan, carton mark, retail package artwork version, insert language, and SKU split into the PSI checklist, then asks TradeAider to verify them with photos and counts.

Result: The inspection finds mixed packaging before final balance payment. The factory sorts affected cartons at source, and the buyer avoids destination relabeling labor and marketplace receiving delay.

Action Card: Build Your Inspection Plan Before the Deposit

Use this sequence before production starts, then revise it after every shipment.

  • Freeze the approved sample, specs, tolerances, artwork, and packaging files.
  • Rank product risks by safety, function, appearance, label, and return cost.
  • Choose PPI, DPI, PSI, and loading checks based on when risk appears.
  • Define AQL level, defect classes, and zero-tolerance checks.
  • Specify report photos, measurements, quantities, and carton evidence.
  • Write the release rule: ship, hold, sort, rework, or reinspect.

The inspection plan should be sent before the supplier starts production, not the night before the factory visit. The earlier the factory sees the rules, the more likely the inspection becomes a control point instead of a surprise audit.

For repeat orders, keep a living checklist. Add the last shipment's defects, customer complaints, packaging issues, and supplier corrective actions. A static plan slowly becomes obsolete; a revised plan becomes a buyer asset.

If you are preparing a manufacturing order and need an inspection plan that can actually support release decisions, send TradeAider the product spec, approved sample photos, PO, destination market, defect concerns, and expected production schedule. The next step is to ask TradeAider to map the inspection checkpoints before production starts.

Frequently Asked Questions

What is a quality inspection plan in manufacturing?

A quality inspection plan defines what will be checked, when it will be checked, how sampling works, what counts as a defect, and how release decisions are made.

When should I create the inspection plan?

Create it before production starts. Waiting until final inspection leaves too many requirements vague and reduces the factory's ability to correct problems at source.

Does AQL decide the whole inspection result?

No. AQL helps with sampled defects, but the plan should also define critical zero-tolerance checks such as wrong SKU, unsafe condition, missing warning, or label mismatch.

Should I use PPI, DPI, or PSI?

Use PPI for readiness and inputs, DPI for process drift, and PSI for finished-lot release. High-risk orders may need more than one checkpoint.

Can TradeAider help create the checklist?

TradeAider can help turn a buyer's product file into inspection checkpoints, AQL settings, special checks, report evidence, and release rules for the actual shipment.

Supply Chain Compliance Content Team

The Supply Chain Compliance Content Team is composed of seasoned consultants specializing in factory audits, supplier management, and supply chain compliance. With extensive expertise in ESG requirements, regulatory standards, and supplier performance evaluation, the team provides practical insights to help businesses strengthen compliance, optimize supplier relationships, and build responsible global supply chains.
